← Tender Teardown

Tender Teardown

Ref Social Housing
9 critical8 high1 medium

This tender involves the design, construction, and delivery of 172 affordable homes in Cherry Orchard, where a fixed-price lump sum contract and extensive transfer of risk demand meticulous commercial scrutiny from bidders.

View public tender source →

Design, Construction and Delivery of Cherry Orchard (Affordable for Sale) Housing Development (Pro405): Tender Teardown

This tender involves the design, construction, and delivery of 172 affordable homes in Cherry Orchard, where a fixed-price lump sum contract and extensive transfer of risk demand meticulous commercial scrutiny from bidders.

This commission concerns the Design, Construction and Delivery of the Cherry Orchard (Affordable for Sale) Housing Development (Pro405), a new residential scheme comprising 172 units. The project is classified under residential real estate and site development work, indicating a comprehensive scope from groundworks through to handover. The contract is structured as a fixed-price lump sum, with an estimated project duration of 28 months.

The fixed-price nature, coupled with the extended programme, immediately flags commercial exposure to market fluctuations. Beyond pricing, the dossier reveals several critical risk transfers, particularly around design responsibility, the reliability of employer-provided information, and the financial implications of performance bonds. Bid teams must carefully unpick these clauses to avoid carrying unpriced liabilities.

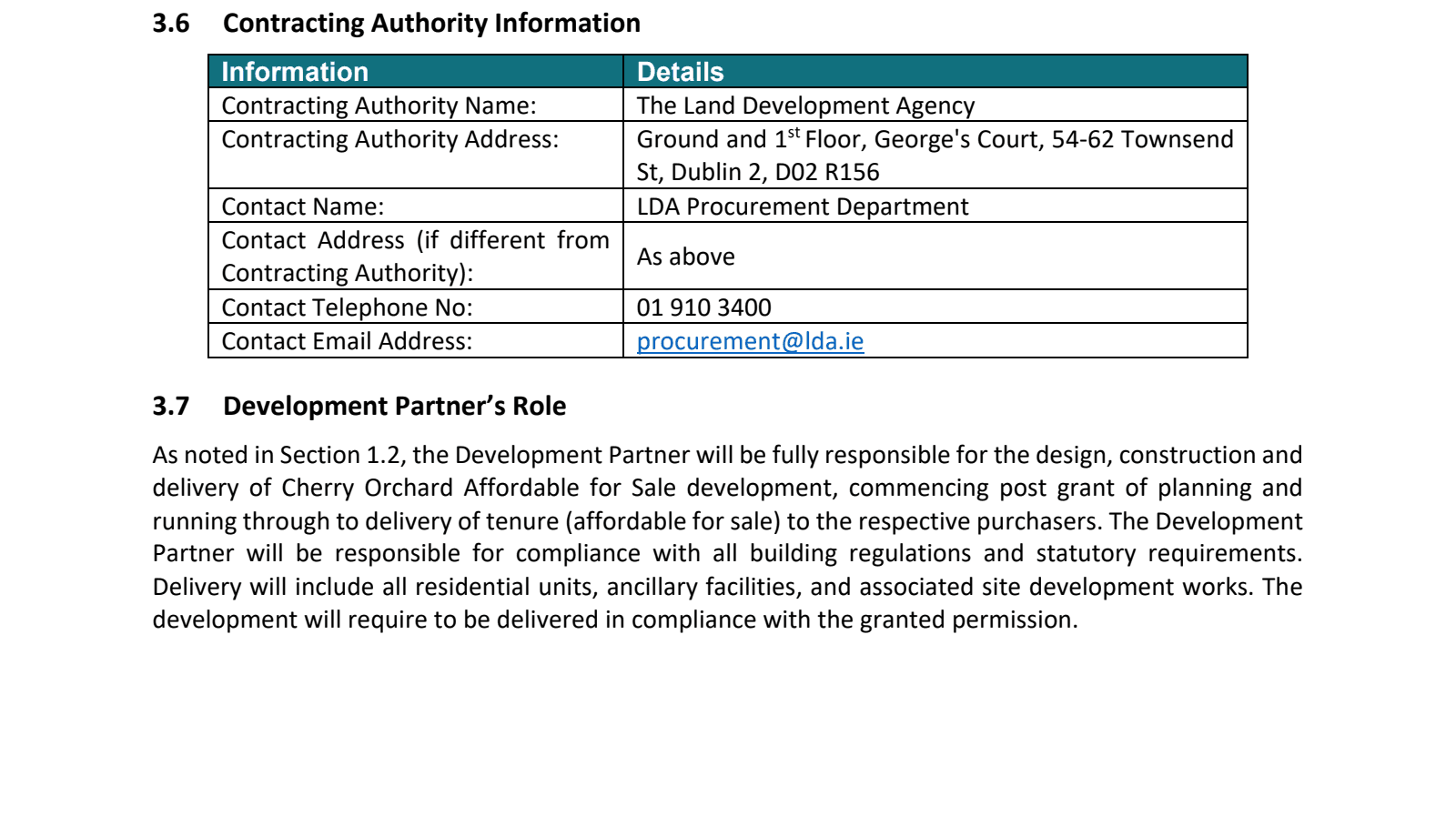

Transfer of Design Responsibility to Development Partner

Critical · Design Responsibility Transfer

The contract explicitly states the Development Partner will be fully responsible for the design, construction, and delivery of the Cherry Orchard scheme, operating to a 'design & build standard'. This is a complete transfer of design liability. It means the contractor owns the entire design process, from developing the detailed design to ensuring its coordination across all disciplines and compliance with all regulations and performance criteria.

This responsibility extends beyond simply producing drawings; it includes managing design interfaces, resolving clashes, and bearing the commercial consequences of any design errors or omissions. Programme delays are a direct consequence if design development proves complex, requires extensive coordination with third parties, or encounters slow approval processes, all of which fall under the contractor's remit. Professional indemnity insurance coverage and robust sub-consultant agreements become critical components of the bid price and delivery strategy.

As noted in Section 1.2, the Development Partner will be fully responsible for the design, construction and delivery of Cherry Orchard Affordable for Sale development

The detailed design will be complete to a design & build standard - primary elements spatially coordinated amongst all design disciplines.

Excerpt from 1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf page 14 highlighting: 'As noted in Section 1.2, the Development Partner will be fully responsible for the design, construction and delivery of …'
1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf, p. 14

What we'd do: Establish a clear design management plan, including a detailed design programme and resource allocation. Ensure all design sub-consultants are appointed on back-to-back terms with appropriate professional indemnity insurance. Price for the full scope of design development and coordination, including a contingency for unforeseen complexities.

Information Provided for Guidance Only with No Warranty

Critical · Site and ground conditions

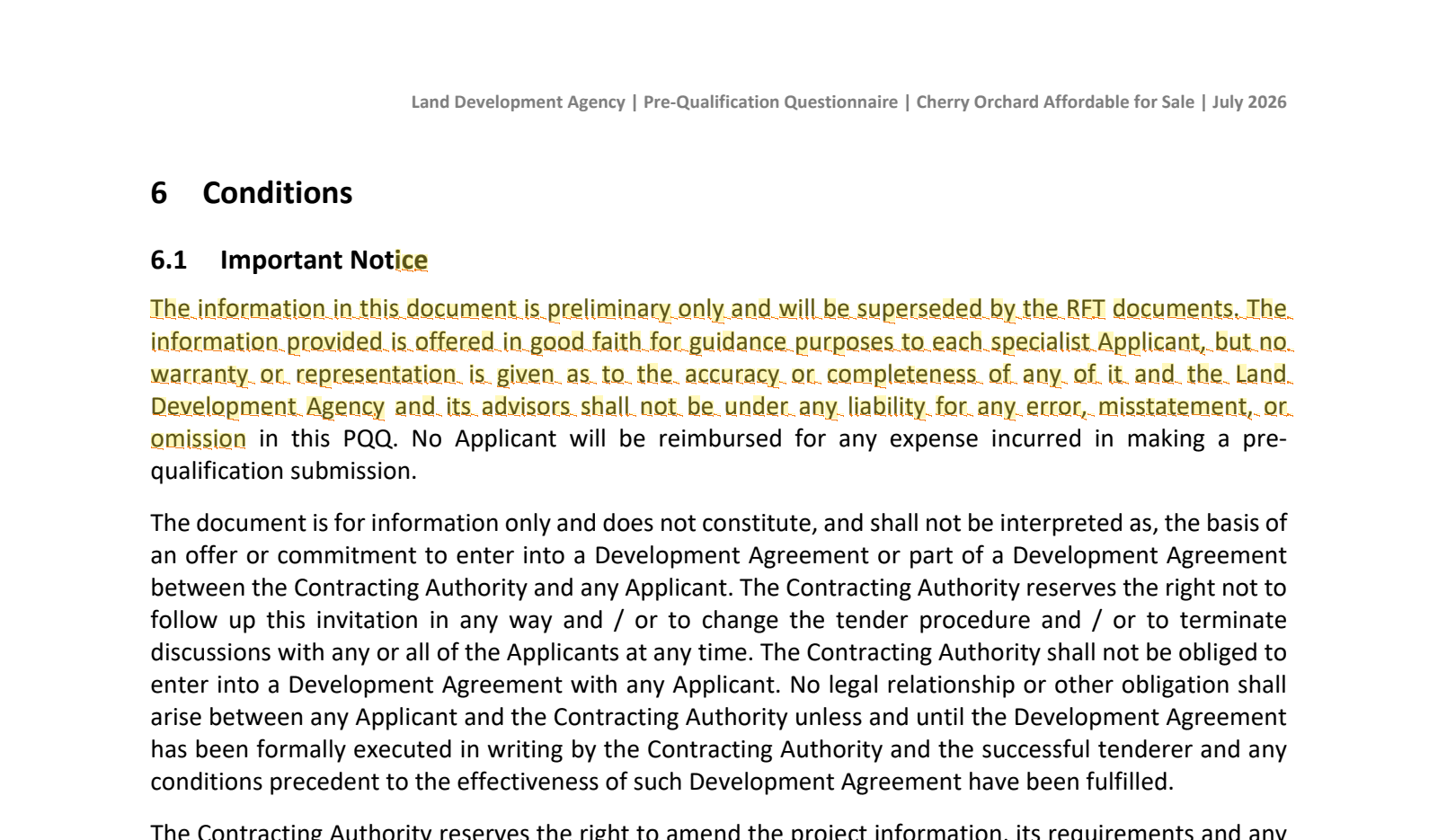

The PQQ states that all provided information is 'preliminary only' and 'for guidance purposes,' with 'no warranty or representation' as to its accuracy or completeness. Furthermore, the Land Development Agency (LDA) disclaims liability for any errors or omissions. This clause is a significant risk transfer, effectively placing the burden of verifying all site information, including ground conditions and existing utilities, onto the contractor.

The dossier notes that GPR and CCTV surveys are incomplete in some areas due to blocked drainage and overgrown vegetation, with additional surveys proposed. This directly links to the 'no warranty' clause, meaning any discrepancies or unknowns regarding existing utilities or ground conditions become the contractor's risk. Bidders cannot rely on the provided data for pricing or programme certainty, necessitating extensive independent due diligence during the tender period. Failure to do so will result in carrying significant latent risk for unforeseen site conditions, which could lead to substantial cost overruns and programme delays.

The information in this document is preliminary only and will be superseded by the RFT documents. The information provided is offered in good faith for guidance purposes to each specialist Applicant, but no warranty or representation is given as to the accuracy or completeness of any of it and the Land Development Agency and its advisors shall not be under any liability for any error, misstatement, or omission in this PQQ.

Excerpt from 1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf page 27 highlighting: 'The information in this document is preliminary only and will be superseded by the RFT documents. The information provid…'
1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf, p. 27

What we'd do: Conduct thorough independent site investigations, including additional GPR/CCTV surveys where feasible, to verify existing conditions. Price for a robust contingency to cover potential unknowns or qualify the bid with specific assumptions regarding ground conditions and utility locations, seeking a contractual mechanism for recovery if conditions deviate.

Performance Bond with Extended Release Schedule

Critical · Specialist Capacity Shortage

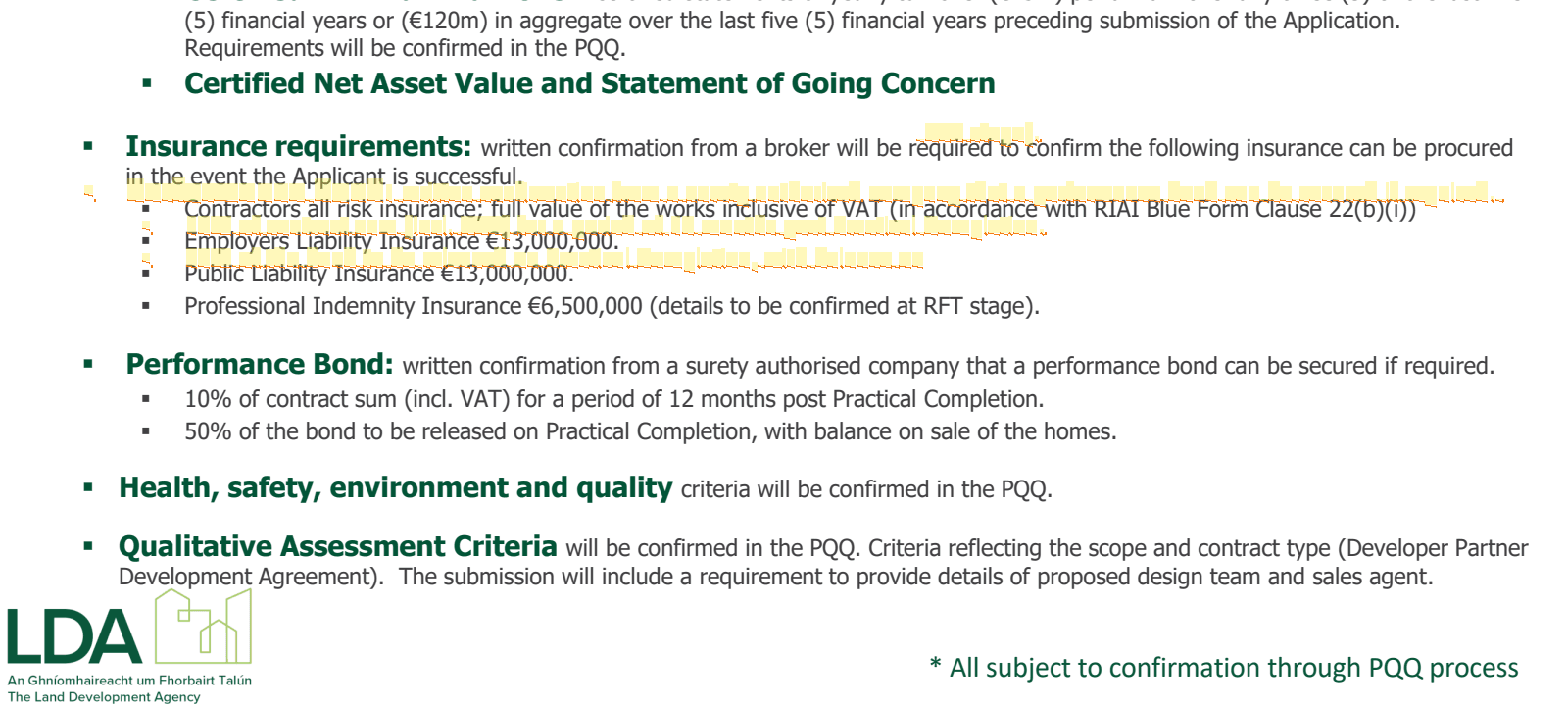

The requirement for a 10% performance bond is at the higher end of typical industry standards. Critically, the release schedule specifies that 50% of the bond is released on Practical Completion, with the 'balance on sale of the homes'. This creates an open-ended and potentially indefinite liability period for the contractor, extending well beyond the standard defects liability period.

This extended liability ties up the contractor's bonding capacity for an uncertain duration, incurring ongoing costs for the bond premium. Surety providers will price this increased risk, potentially leading to higher premiums or a reduced pool of willing providers. This directly impacts the contractor's cash flow and financial flexibility, making it a significant commercial consideration that must be factored into the bid price.

Performance Bond: written confirmation from a surety authorised company that a performance bond can be secured if required. ▪ 10% of contract sum (incl. VAT) for a period of 12 months post Practical Completion. ▪ 50% of the bond to be released on Practical Completion, with balance on sale of the homes.

Excerpt from 1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-Appendix B - Presentation-LDA_Cherry Orchard AFS Market Engagement Event.pdf page 36 highlighting: 'Performance Bond: written confirmation from a surety authorised company that a performance bond can be secured if requir…'
1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-Appendix B - Presentation-LDA_Cherry Orchard AFS Market Engagement Event.pdf, p. 36

What we'd do: Seek urgent clarification from the client on the expected duration for the 'sale of the homes' and attempt to negotiate a fixed, time-bound release schedule for the balance of the bond, ideally linked to the end of the defects liability period. If negotiation is not possible, explicitly price the extended liability and associated costs into the tender return.

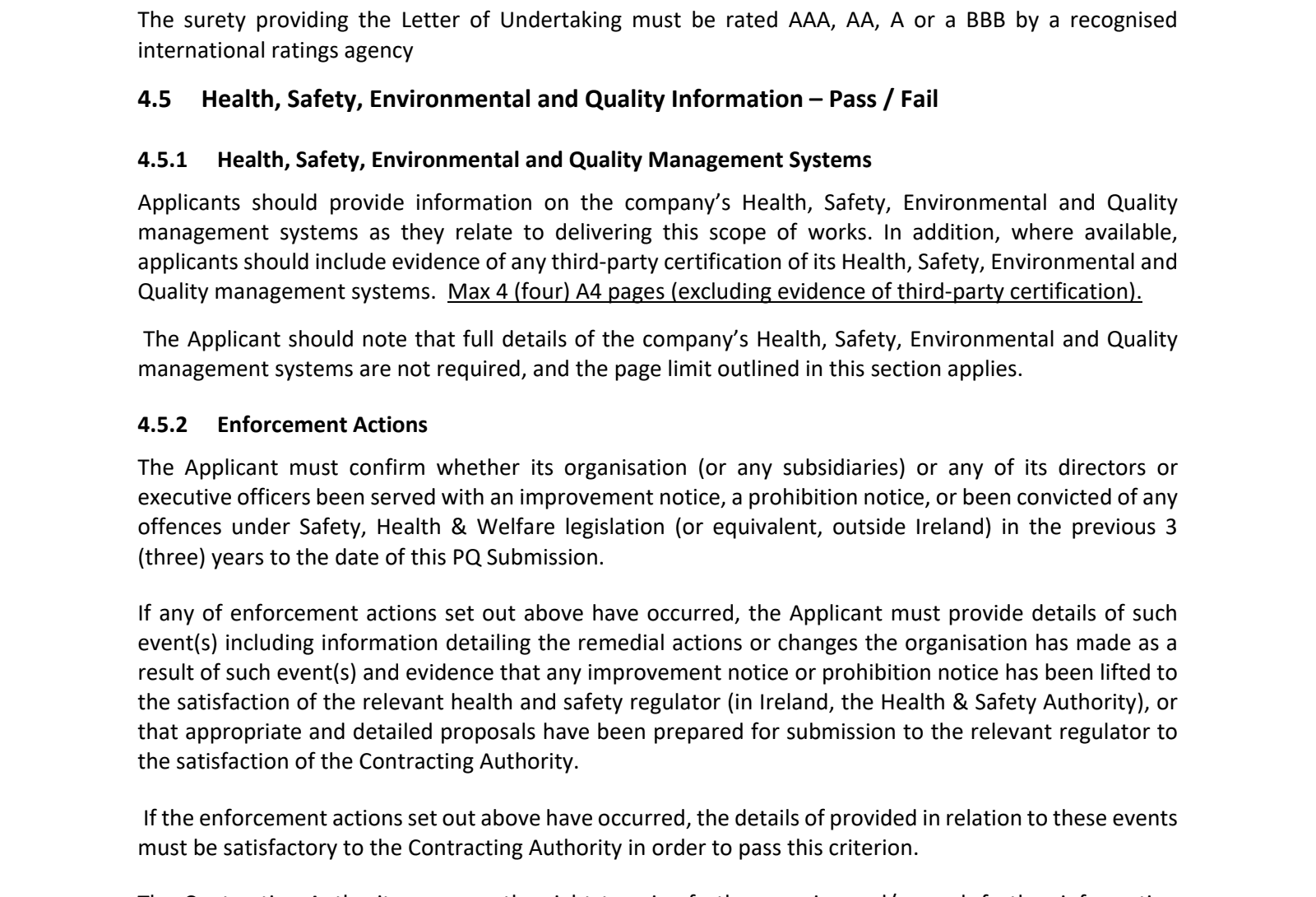

Past Environmental, Social, or Health & Safety Breaches

Critical · Hse Duty Ambiguity

Applicants are required to self-declare any past breaches of environmental, social, or labour law, or enforcement actions under Safety, Health & Welfare legislation within the previous three years. Failure to provide satisfactory details or having a history deemed unacceptable by the Contracting Authority could lead to exclusion from the competition.

This is a direct pre-qualification hurdle. It means that even a commercially competitive bid could be rejected if the contractor's past compliance record is not robust or if any breaches are not adequately explained with evidence of remedial action. Bid teams must conduct a thorough internal review of their compliance history and prepare a clear, evidence-backed response for any declared incidents, demonstrating effective management and learning.

C.1 Has the economic operator, to its knowledge, breached its obligations in the fields of environmental, social and labour law (19)? Yes No

The Applicant must confirm whether its organisation (or any subsidiaries) or any of its directors or executive officers been served with an improvement notice, a prohibition notice, or been convicted of any offences under Safety, Health & Welfare legislation (or equivalent, outside Ireland) in the previous 3 (three) years to the date of this PQ Submission.

Excerpt from 1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf page 16 highlighting: 'The Applicant must confirm whether its organisation (or any subsidiaries) or any of its directors or executive officers …'
1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf, p. 16

What we'd do: Conduct a comprehensive internal audit of all environmental, social, labour, and H&S compliance records for the past three years. For any identified breaches or enforcement actions, prepare a detailed explanation of the circumstances, remedial actions taken, and evidence of improved systems. Ensure this information is presented clearly and transparently in the bid submission.

Failure to Achieve Home Performance Index Certification

Critical · Environmental Control Gap

The development is contractually required to achieve Home Performance Index Certification with the Irish Green Building Council upon completion. The successful contractor must provide information and input into this process. This is a specific, measurable environmental performance target, not a general aspiration.

Failure to secure this certification would constitute a direct breach of contract, potentially leading to financial penalties, withholding of payments, or reputational damage. It demands that the contractor integrates the certification requirements into every stage of the project, from detailed design and material selection to construction practices and commissioning. This is a core deliverable that requires dedicated resources and expertise to manage and achieve.

The development is to achieve Home Performance Index Certification with the Irish Green Building Council on completion, and the successful Works Contractor will be required to provide information and input into this process.

Excerpt from 1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf page 5 highlighting: 'The development is to achieve Home Performance Index Certification with the Irish Green Building Council on completion, …'
1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf, p. 5

What we'd do: Integrate Home Performance Index Certification requirements into the project's design, procurement, and construction quality plans. Appoint a dedicated resource responsible for managing the certification process, coordinating with the Irish Green Building Council, and ensuring all necessary information and input are provided throughout the project lifecycle.

Late or Unsuccessful Electronic Submission

Critical · Portal Submission Failure

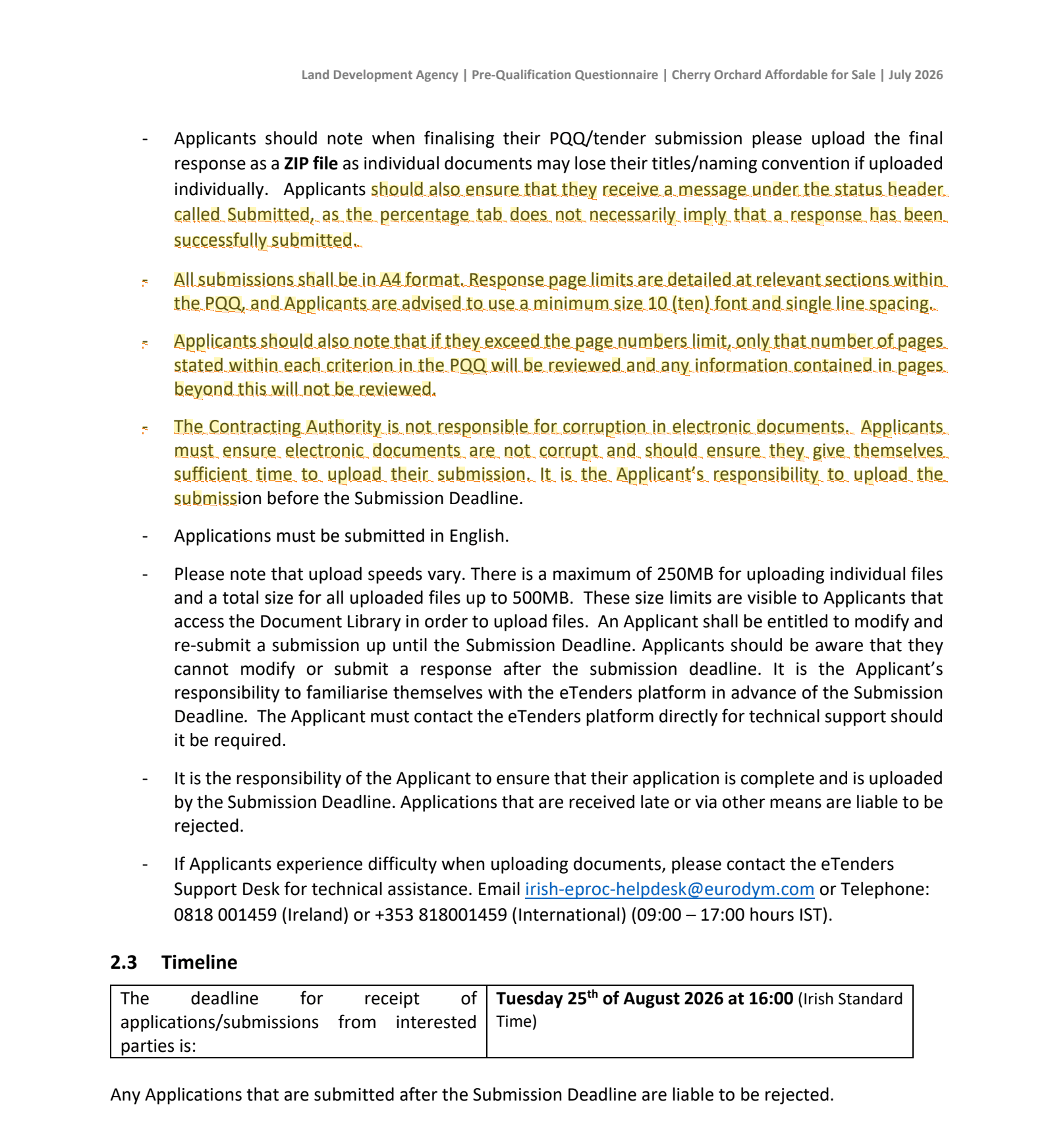

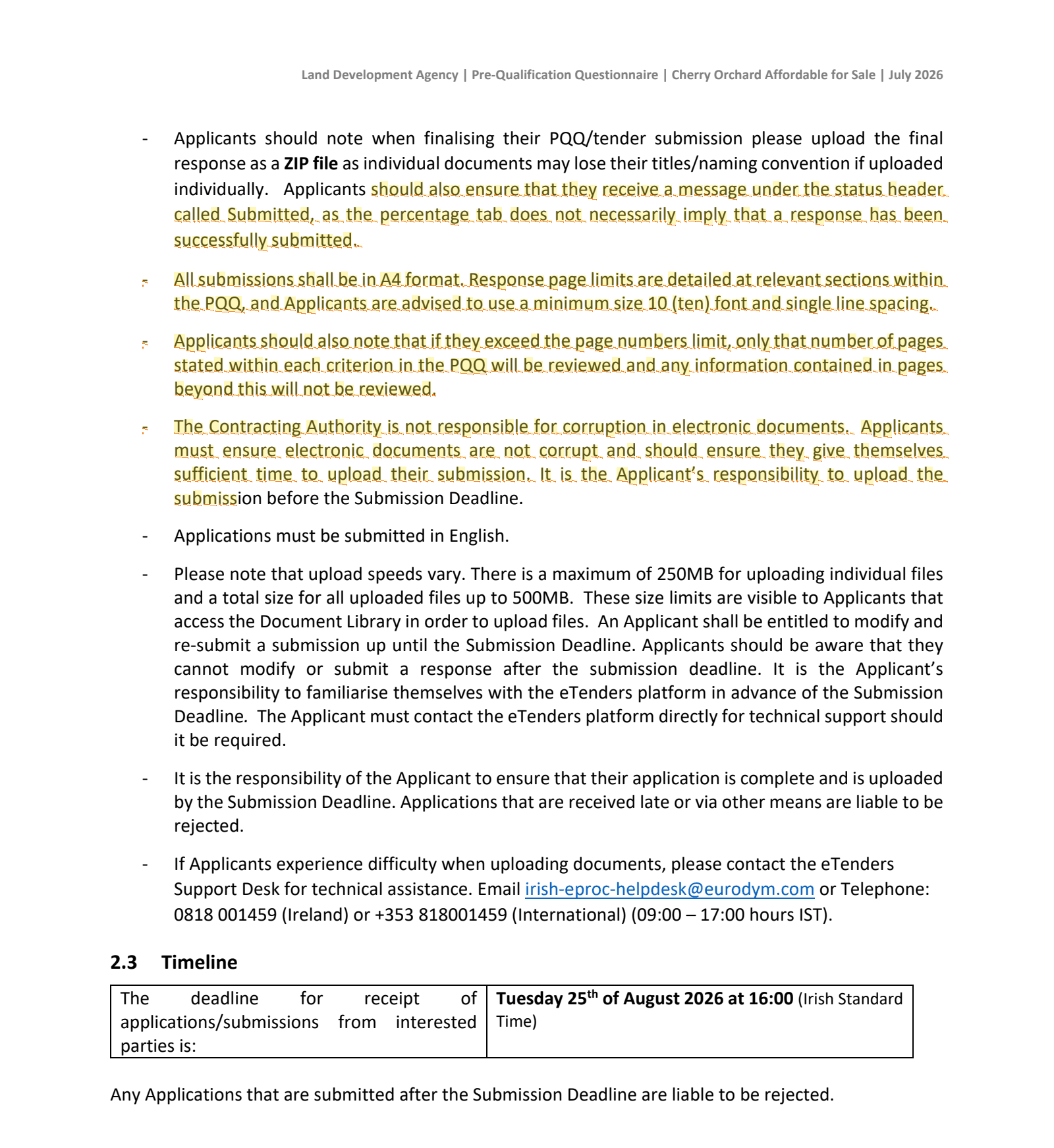

The tender documents explicitly state that applications submitted after the deadline of Tuesday 25th August 2026 at 16:00 (Irish Standard Time) are liable to be rejected. Furthermore, it is the applicant's responsibility to ensure successful upload to the eTenders platform, specifically verifying the 'Submitted' status message, as the percentage tab alone does not guarantee submission.

This is a critical procedural risk that can lead to immediate disqualification, regardless of the quality of the bid content. The eTenders platform can be temperamental, and technical issues, internet connectivity problems, or simple oversight of the 'Submitted' message can derail an entire bid effort. This demands meticulous attention to the submission process and timing, with no room for last-minute rushes.

It is the Applicant ’s responsibility to upload the submission before the Submission Deadline. ... Applicants should a lso ensure that they receive a message under the status header called Submitted, as the percentage tab does not necessarily imply that a response has been successfully submitted.

The deadline for receipt of applications/submissions from interested parties is: Tuesday 25th of August 2026 at 16:00 (Irish Standard Time) Any Applications that are submitted after the Submission Deadline are liable to be rejected.

Excerpt from 1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf page 11 highlighting: 'It is the Applicant ’s responsibility to upload the submission before the Submission Deadline. ... Applicants should a l…'
1_LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26-LDA Cherry Orchard AFS - Development Partner PQQ_PRO405_24.07.26.pdf, p. 11

What we'd do: Implement a strict internal deadline for submission at least 24-48 hours before the official deadline. Conduct a dry-run submission on the eTenders platform well in advance to familiarise the team with the process. Ensure the 'Submitted' status message is explicitly confirmed and documented after the final upload.

The rest of the picture

The fixed unit costs for affordable homes, specified in the Development Agreement, expose the contractor to material and labour price fluctuations over the 28-month project duration, demanding careful inflation forecasting and robust supply chain agreements.

Takeaways
